Costs

Task-level costs let you track expenses that apply specifically to a single task. These costs can be fixed or variable, and each behaves differently in the schedule. Task costs are optional but extremely useful when you want accurate budget tracking, cash-flow forecasting, or high-level cost estimates.

Types of Task Costs

1. Fixed Costs

Fixed costs stay the same regardless of how long the task actually takes.

Examples:

  • Permit fee
  • Equipment rental flat fee
  • One-time subcontractor charge
  • Testing or inspection fees

A fixed cost applies once to the task and does not increase or decrease if the task is completed earlier or later than originally planned.

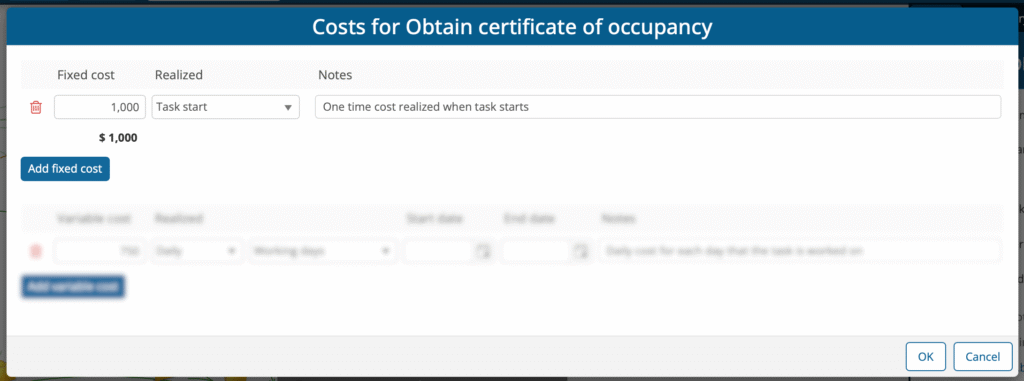

When are fixed costs realized?

When adding a fixed cost, you can choose how the cost is realized in the schedule:

  • Date – you choose the exact date.

  • Plan start – realized on the first day of the plan.

  • Project start – realized when the project’s start date occurs.

  • Task start – realized when the task actually begins.

  • Evenly distributed – spread across the days the task is scheduled to run.

If you select Evenly distributed, you can further choose whether the distribution occurs on:

  • All Days

  • Weekdays

  • Working days (based on the resource calendar)

This setting matters because BuilderPlan/GamePlan can generate a daily cost schedule, which many users rely on for cash-flow forecasting.

2. Variable Costs

Variable costs scale based on how long the task takes. They can be defined as:

  • Hourly

  • Daily

Examples:

  • Renting equipment priced per hour/day
  • Using materials over time
  • Estimation of labor costs if no resources are assigned

Variable costs are automatically recalculated if the task’s actual duration changes.

When to Use Task Costs vs. Resource Costs

If your task is resource loaded, and the resources have hourly or daily cost rates assigned to them, the software will automatically calculate labor costs. In these cases:

👉 Do NOT add duplicate variable costs at the task level.

Task-level variable costs are helpful when:

  • You’re planning at a high level and haven’t assigned resources

  • You want to simulate time-based expenses without modeling resources

  • The task has non-labor variable costs (e.g., equipment rental billed hourly)

Variable Cost Date Ranges

Variable costs allow start and end dates.  Leave this blank for the entered variable cost to apply for the entire schedule.

Why this matters:

Costs may change over time, especially for longer schedules.

Examples:

  • Hourly subcontractor rates increase annually

  • Daily equipment rental changes after a promotional period

  • Inflation needs to be considered for long-term schedules

By using multiple variable cost entries with different date ranges, you can accurately represent rate changes over the life of the schedule.

Viewing Task Costs in the Schedule

Costs for each task are calculated and can be viewed in the following locations:

  • Whiteboard
  • Project Summary
  • Data panel > Tasks
  • Tasks report
  • Excel export

Costs for each task will soon be able to be displayed as a column in the Gantt chart.

If no costs exist, the Costs section is collapsed automatically. If costs do exist, the section automatically expands so you know they are there.

Summary

Cost TypeUse WhenBehavior
Fixed costOne-time expenseSame regardless of task duration
Variable costTime-based expenseScales with actual duration
Resource costsLabor resources assignedAutomatically calculated

💡 Tips

  • Use fixed costs for one-off expenses or commitments.

  • Use variable costs only when no resource rates exist or you need non-labor time-based costs.

  • Use date ranges to model rate increases over time.

  • Use Evenly distributed fixed costs when you need accurate cash flow forecasting across calendar days.
